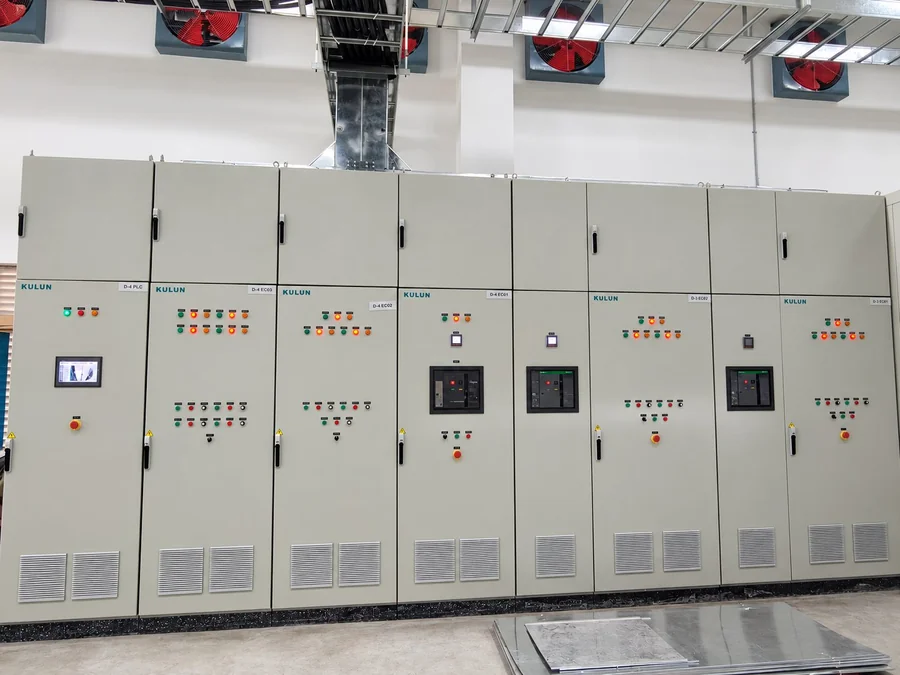

29.7 MW Pipeline Air Heating MV Cabinet Case

Bottom line first: on 10 October 2026, Sichuan Kulun Electric (KULUN) commissioned multiple APR3L-1200V-1000A medium-voltage power control cabinets on a pipeline air heating project in Sichuan. Together they form a 29.7 MW electric heating control system. Each cabinet is rated 1200 V / 1000 A, about 2.08 MW in three-phase service, and regulates its own heater zone with continuous power control and a temperature loop. This article explains, in plain language, what the system does on site, why a 1200 V medium-voltage class was chosen, what to check before buying a similar set, and how commissioning usually runs.

Pipeline air heating warms moving air. Air heats and cools quickly, and the load follows the flow rate, so the supply must do more than switch on and off — it has to raise and lower power smoothly with the process. The 29.7 MW total is shared across multiple APR3L-1200V-1000A cabinets, one per heater section. Phase-angle fired thyristor control was chosen so temperature overshoot and hard current shocks stay smaller than with a contactor on/off scheme.

What does the system do on this site?

The heater is split into zones. Each APR3L-1200V-1000A cabinet serves only its own zone and does three jobs:

  1. Delivers grid power to that zone’s heating elements with continuous 0–100% regulation.
  2. Takes the setpoint from the local temperature controller or PLC and holds outlet air temperature near the process target.
  3. Limits or cuts output on overcurrent, phase loss or overtemperature, so a fault stays inside that zone as far as practical.

For a low-inertia medium like air, continuous regulation usually keeps the temperature band tighter and makes cold-start current easier to manage than on/off switching.

Why consider a 1200 V medium-voltage class at this power?

29.7 MW is the system total; each cabinet is about 2.08 MW. Voltage class is not guessed first and matched later — it is worked out from per-cabinet power and allowable current together.

In plain terms: the same ~2.08 MW draws about 3000 A at 400 V, but about 1000 A at 1200 V — roughly one third of the current. Lower current means less copper in cable and busbar, lower line loss, and less heat stress on joints and thyristors. (The check is three-phase power P ≈ √3 × U × I: √3 × 1200 V × 1000 A ≈ 2078 kW, which matches the ~2.08 MW per-cabinet figure.)

Higher is not always better. Raising voltage tightens insulation, creepage and safe-operating rules inside the cabinet. The usual path is: follow the existing site busbar first; step up only when a low-voltage design carries so much current that it becomes clearly uneconomic. 1200 V sits on the low/high boundary and is commonly called medium voltage on site.

Key ratings of the APR3L-1200V-1000A

ItemValueNote
ModelAPR3L-1200V-1000AMedium-voltage power control cabinet
Rated output voltage1200 VFrom site busbar and load power
Rated output current1000 AFrom load power and duty
PhasesThree-phaseMatches the site supply
Rated capacity per cabinetApprox. 2.08 MW√3 × 1200 V × 1000 A
System total power29.7 MWMultiple APR3L-1200V-1000A cabinets, one per zone
DutyPipeline air heatingMoving air; load follows flow
Commissioned10 October 2026After site commissioning

Note: in the KULUN low-voltage multi-function line, models such as the ST200 are publicly rated AC10~1500A. This project uses a medium-voltage non-standard cabinet — do not copy LV ratings onto a 1200 V unit.

What to check when selecting for a similar duty

Check itemBasisCommon mistake
Supply voltage class and frequencyFixed by the existing site busbarWriting a preferred value and finding a mismatch on delivery
Rated output current per cabinetFrom load power and continuous duty, with marginSizing from cold or hot resistance only, undersizing
System total power and number of cabinetsTotal process load ÷ per-cabinet capacity, then zoningTotal power and per-cabinet capacity do not match
Load resistance behaviourCold vs hot resistance of the elementsIgnoring cold-start inrush and overloading at start-up
Control modeConstant voltage, current or power vs process needOpen-loop manual control where a temperature loop is required
Control signal and interface4–20 mA / 0–10 V or a bus, matched to the hostInterface differs from the PLC side — rework on site
Cooling methodInternal heat loss plus site ventilationCounting device losses only; ignoring ducts and inlet air
Protection and insulationVoltage class and site safety rulesCopying low-voltage cabinet practice onto a medium-voltage design
Zoned operationCapacity and control set per zone heat load and air flowCopying another zone’s settings

How is commissioning sequenced on site?

A 29.7 MW system normally follows this order. Do not start the next step until the previous one passes, and keep a written record:

  1. Delivery inspection and visual check
  2. Insulation resistance and withstand test
  3. Individual no-load energisation and firing-waveform check
  4. Per-zone energisation and output verification
  5. On-load heat-up with voltage and current records
  6. Closed-loop parameter tuning
  7. Continuous run assessment

The two steps that affect the process most are usually per-zone verification and closed-loop tuning. With each APR3L-1200V-1000A running its own zone, confirm zone by zone that the setpoint and feedback come from that zone’s temperature and current, and that limits match that zone’s element rating so no single zone is overloaded. Because the load follows air flow, tune proportional and integral terms across the real flow range — do not copy another furnace type. After tuning, verify at least one point in each commonly used flow band and keep the temperature swing inside the process window.

FAQ

Is 1200 V medium voltage or high voltage?

In common Chinese practice, AC up to and including 1 kV is called low voltage; anything above 1 kV falls into the high-voltage category, and the lower part of that range is often called medium voltage on site. The 1200 V rating of the APR3L-1200V-1000A sits on that boundary. For selection, the name matters less than three checks: the actual site busbar voltage, the insulation level required, and the operational safety rules that apply.

Why is the 29.7 MW system built from multiple cabinets instead of one large unit?

A single 29.7 MW cabinet would push paralleling, enclosure size, transport and maintenance access up sharply in difficulty and cost. Splitting the load into multiple ~2.08 MW APR3L-1200V-1000A cabinets gives each zone its own control and protection. One cabinet can be serviced while the others keep running, and power can be staged or zoned more easily.

Why not use contactor on/off control for pipeline air heating?

Moving air has low thermal inertia. On/off control makes temperature swing around the setpoint and adds a current inrush every time the contactors close. A phase-angle fired thyristor cabinet regulates power continuously, follows flow and temperature smoothly, keeps a narrower temperature band, and reduces thermal shock on the heating elements.

Is a 400 V design workable for a ~2 MW air heater?

It is technically possible, but the cost is current. About 2.08 MW draws roughly 3000 A at 400 V and about 1000 A at 1200 V — about a threefold difference. Copper in cable and busbar, line loss and internal heating all rise with current. Whether to step up the voltage class should compare first cost with long-term loss, not the cabinet price alone.

What data is needed to enquire about a medium-voltage power control cabinet?

Prepare at least seven items: supply voltage class and frequency; rated output voltage and current; load type and resistance behaviour; control mode; cooling method; protection and insulation requirements; and the control or communication interface. With these fixed, the cabinet scheme and lead time can be quoted accurately. Missing items force a quote on assumptions and leave a lot of room for later change.

Can an existing cabinet be replaced directly during a retrofit?

Direct drop-in replacement is not recommended. Check four things first: whether the existing output voltage and current cover the new load; whether the control signal form matches the host system; whether enclosure size and cable entry match the site foundation; and whether the site busbar voltage still matches the original design. Only then decide between a full cabinet change and a control-section retrofit.

Timeliness note

This article is based on Sichuan Kulun Electric commissioning information dated 10 October 2026 for a pipeline air heating project. It covers the role, selection checks and commissioning order of medium-voltage power control cabinets in this duty. The 29.7 MW system total, about 2.08 MW per cabinet, and model APR3L-1200V-1000A come from the published commissioning article; busbar conditions, zone count and process limits follow the site technical agreement. Current comparisons illustrate the principle only and do not represent a full parameter set for any one project.
